Ikungu Project

Ikungu Project

Located on the Ikungu Peninsula, approximately 45 km from the Seka processing plant.

Project Overview

Located on the Ikungu Peninsula, approximately 45 km from the Seka processing plant. In-house measured and indicated mineral resources stand at 1,307.50 Kt of ore with an average gold grade of 2.25 g/t — equating to 2.93 tons (94.48 Koz) of gold. Underground mining infrastructure was constructed in early 2024, with initial production commenced in January 2025.
License
Type
Status
ML 369/2020
Mining
Active to 2030
ML 0797/2025
Mining
Newly granted in 2025
PL/11786/2022
Prospecting
Ikungu Perimeter
Ikungu regional geology and license footprint

Underground Development at Ikungu

Construction of surface infrastructure for the underground mine commenced in January 2023. The construction of major underground workings started in December 2024, with initial production beginning in mid-January 2025.
Monthly ore production during the early phase was approximately 5,000 tons and is currently increasing toward 10,000 tons as the operation ramps up.

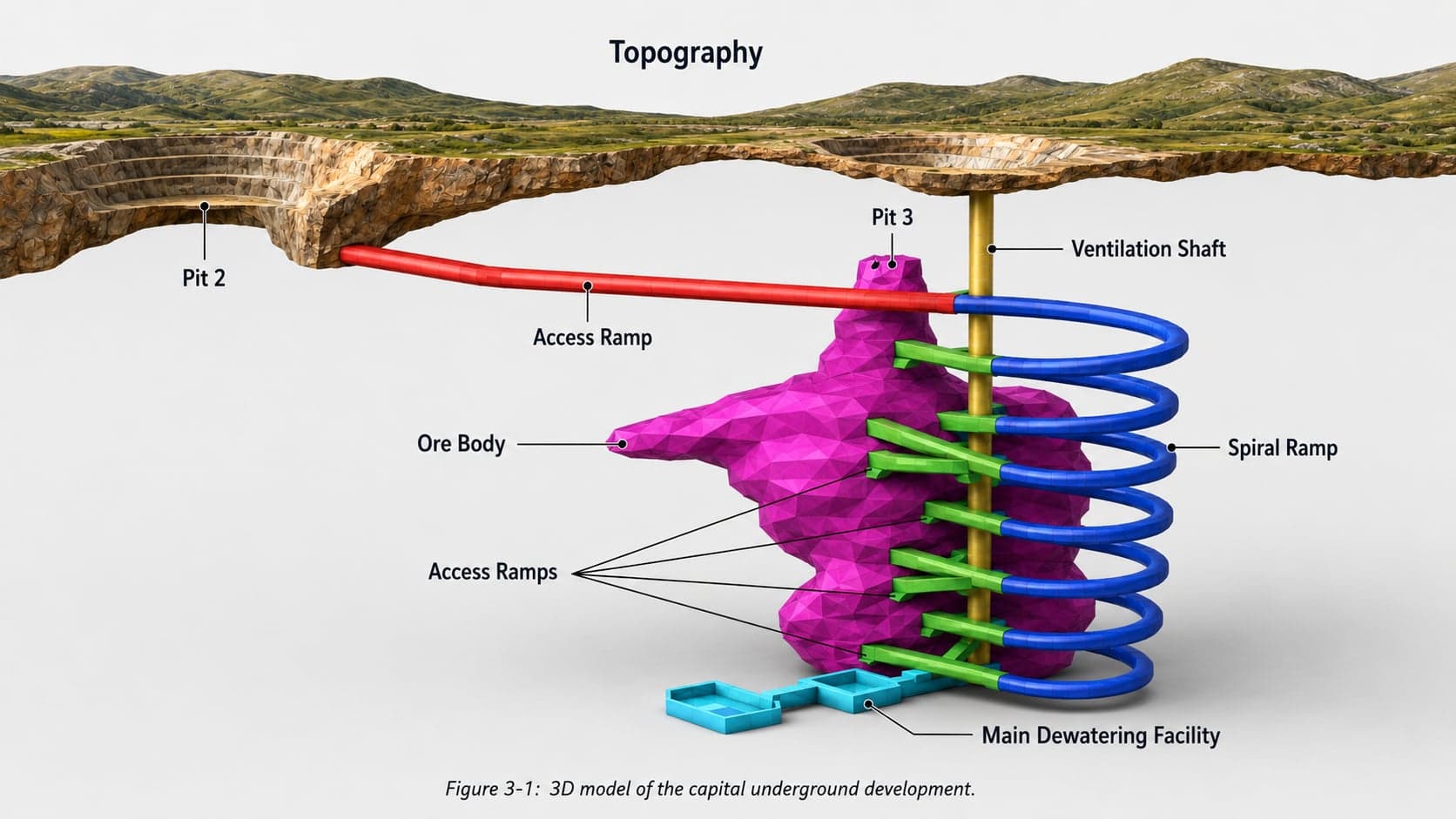

Ikungu underground 3D mine design
Ikungu underground production — ramp-up phase

Production Ramp-Up (5,000 → 10,000 t/month)

Underground throughput is now in its ramp-up phase: early monthly production around 5,000 tons is being scaled toward a steady-state of 10,000 tons per month through stope sequencing, fleet utilization improvements, and additional ventilation capacity.

Ore from Ikungu is hauled to the central CIP plant for processing, with Doré bars produced on-site.

Ikungu Development Timeline

Period
Milestone
Jan 2023
Construction of surface infrastructure begins
Dec 2024
Major underground workings commence
Jan 2025
Initial underground production
2025
New mining license ML 0797/2025 granted
Ongoing
Production ramping up from 5,000 to 10,000 t/month
